CONSTRUCTION
RECORD
Offshore Construction
2022/09/28
Finished the installation of all 33 wind turbines. On September 24, 2022, the installation of the last wind turbine at Akita Port was finished. By this, the installation of all 33 wind turbines consisting of 20 at Noshiro Port and 13 at Akita Port was finished.
2022/07/04
Started Full-scale offshore wind turbine construction. On July 2, 2022, we started full-scale offshore wind turbine construction at Noshiro Port deploying Seajacks Zaratan, a self-propelled SEP (Self-Elevating Platform).
2022/06/15
Seajacks Zaratan has arrived at Akita Port. On June 15, 2022, Seajacks Zaratan, a self-propelled SEP (Self-Elevating Platform), arrived at Akita Port.
2022/04/11
The pre-assembly work of wind turbine towers started. On April 6, 2022, the pre-assembly work of wind turbine towers started at Akita Port.
2022/02/10
The 6th ship has arrived at Akita Port. On February 10, 2022, the 6th ship loaded with 11 towers as wind turbine element arrived at Akita Port.
2022/02/09

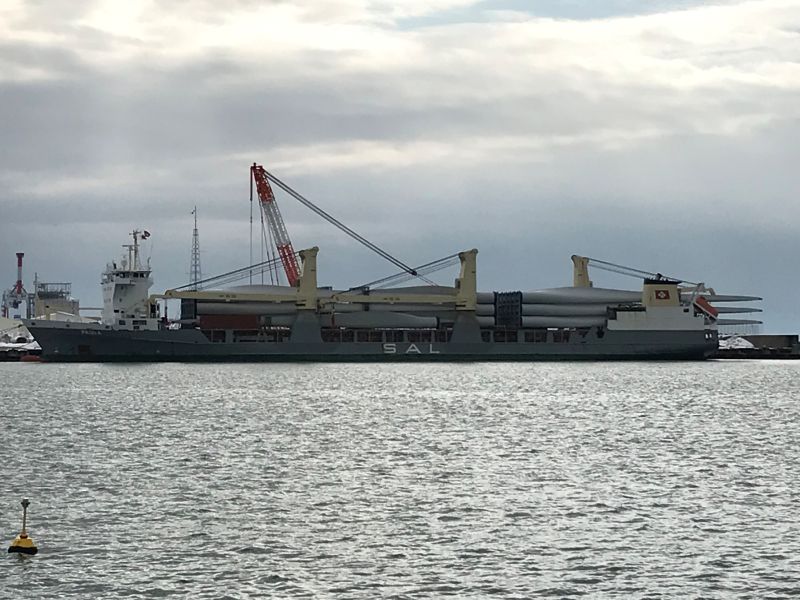

The 5th ship has arrived at Akita Port. On February 8, 2022, the 5th ship loaded with 21 blades as wind turbine element arrived at Akita Port.
2022/01/24
The 4th ship has arrived at Akita Port. On January 23, 2022, the 4th ship loaded with 16 nacelles and 49 blades as wind turbine element arrived at Akita Port.
2022/01/17
The 3rd ship has arrived at Akita Port. On January 16, 2022, the 3rd ship loaded with 11 towers as wind turbine element arrived at Akita Port.
2021/12/27
The 2nd ship has arrived at Akita Port. On December 24, 2021, the 2nd ship loaded with 17 nacelles and 30 blades as wind turbine element arrived at Akita Port.
2021/12/14
The 1st ship has arrived at Akita Port. On December 12, 2021, the 1st ship loaded with 11 towers as wind turbine element arrived at Akita Port.
2021/09/21
Finished hammering all the monopiles. On September 19, 2021, hammering the last monopile (MP) at Akita Port was finished. On the same day, the last transition piece (TP) was also installed.
2021/05/12
Started Full-scale offshore foundation construction. On May 12, 2021, we started full-scale offshore foundation construction at Noshiro Port by deploying Seajacks Zaratan, a self-propelled SEP (Self-Elevating Platform).
2021/04/16
Seajacks Zaratan has arrived at Akita Port. On April 16, 2021, Seajacks Zaratan, a self-propelled SEP (Self-Elevating Platform), arrived at Akita Port. It was the first in history for Seajacks Zaratan to enter a port in Japan.
2021/04/08
The 5th ship has arrived at Akita Port. On April 2, 2021, the 5th ship loaded with 3 monopiles and 11 transition pieces as foundation element arrived at Akita Port.
2021/03/16
The 4th ship has arrived at Akita Port. On March 16, 2021, the 4th ship loaded with 4 monopiles and 11 transition pieces as foundation element arrived at Akita Port.
2021/03/08
The 3rd ship has arrived at Akita Port. On March 5, 2021, the 3rd ship loaded with 3 monopiles and 11 transition pieces as foundation element arrived at Akita Port.
2021/02/26
The 2nd ship has arrived at Akita Port. On February 22, 2021, the 2nd ship loaded with 14 monopiles as foundation element arrived at Akita Port.
2021/01/13
The 1st ship has arrived at Akita Port. On January 12, 2021, the 1st ship loaded with 9 monopiles as foundation element arrived at Akita Port.
